Sohae Satellite Launching Station: Modernization Efforts Continue Apace

Commercial satellite imagery reveals modernization efforts at North Korea’s Sohae Satellite Launching Station have steadily progressed since the failed launch of a Malligyong-1-1 reconnaissance satellite in May 2024. As part of Kim Jong Un’s instructions to expand and modernize the facility, several construction projects—such as a new horizontal assembly building and rail spur connecting the site’s entrance to the coastal roadway—continue to progress.

While the site appears to remain ready for future tests, no signs point to an imminent launch.

New Assembly Building

The new probable assembly building appears ready for the installation of roof trusses. A crane with extendable arm is visible inside of the structure on imagery from September 23. Additionally, three trusses are visible on the ground alongside the building.

Around the outside of the building, large, concrete slabs are being laid and the new road, extended from the east end of the building connecting to the west tunnel entrance, now meets the wider road.

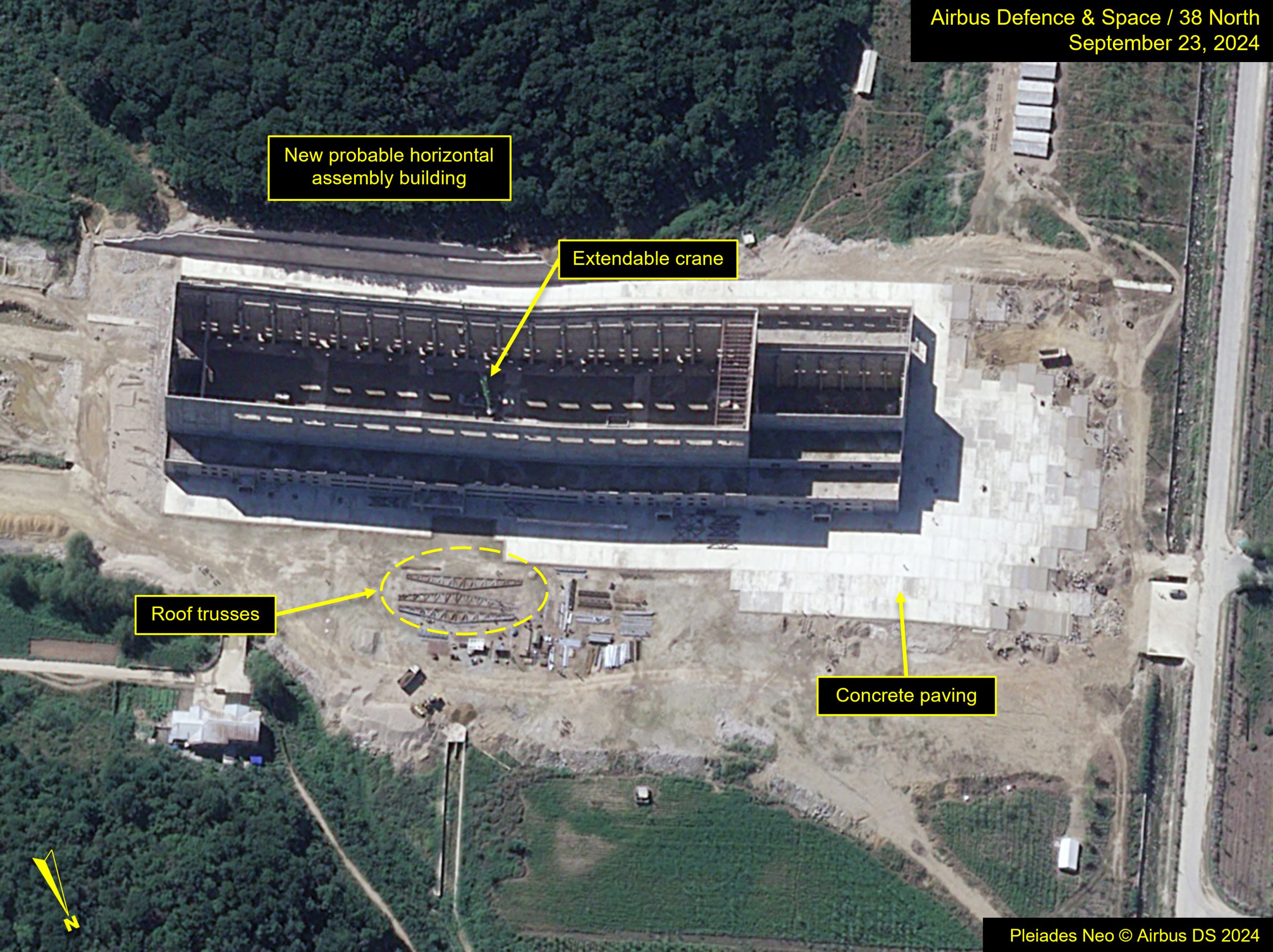

Figure 1. Overview of activity at the new probable assembly building. An extendable crane is parked inside, and paving is underway surrounding the building. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

Towards the entrance of the site, just north of the rail transfer station, work on a new rail spur is progressing and dirt is being deposited in what will become the bed of the new tracks. The preparation work indicates the new spur will run from a point north of the transfer building, likely bypassing the new assembly building and heading towards the tunnel. This could explain the widening work taking place on the road between the new assembly building and the west tunnel entrance.

Six empty ore cars, having deposited their loads, are located where the work to build up the railroad base is ongoing. Another six ore cars with a locomotive, and full of aggregate, are queued 1.2 kilometers northeast of the complex, waiting their turn to deposit their content.

Figure 2. Work on the new rail spur that connects the site’s entrance to the new probable horizontal assembly building and west tunnel entrance continues. The rail bed nears connectivity to the existing track. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

Tunnel Area

West Tunnel Area

At the west tunnel, an unidentified object—possibly related to construction— is observed inside the tunnel on imagery from September 23. Several arch trusses are seen in the nearby area, indicating that this new rectangular opening will likely be covered with a roof. However, the nearby roof trusses are too short to span the existing opening. It is possible each truss is half of a piece that will be connected by a ridge beam in the center.

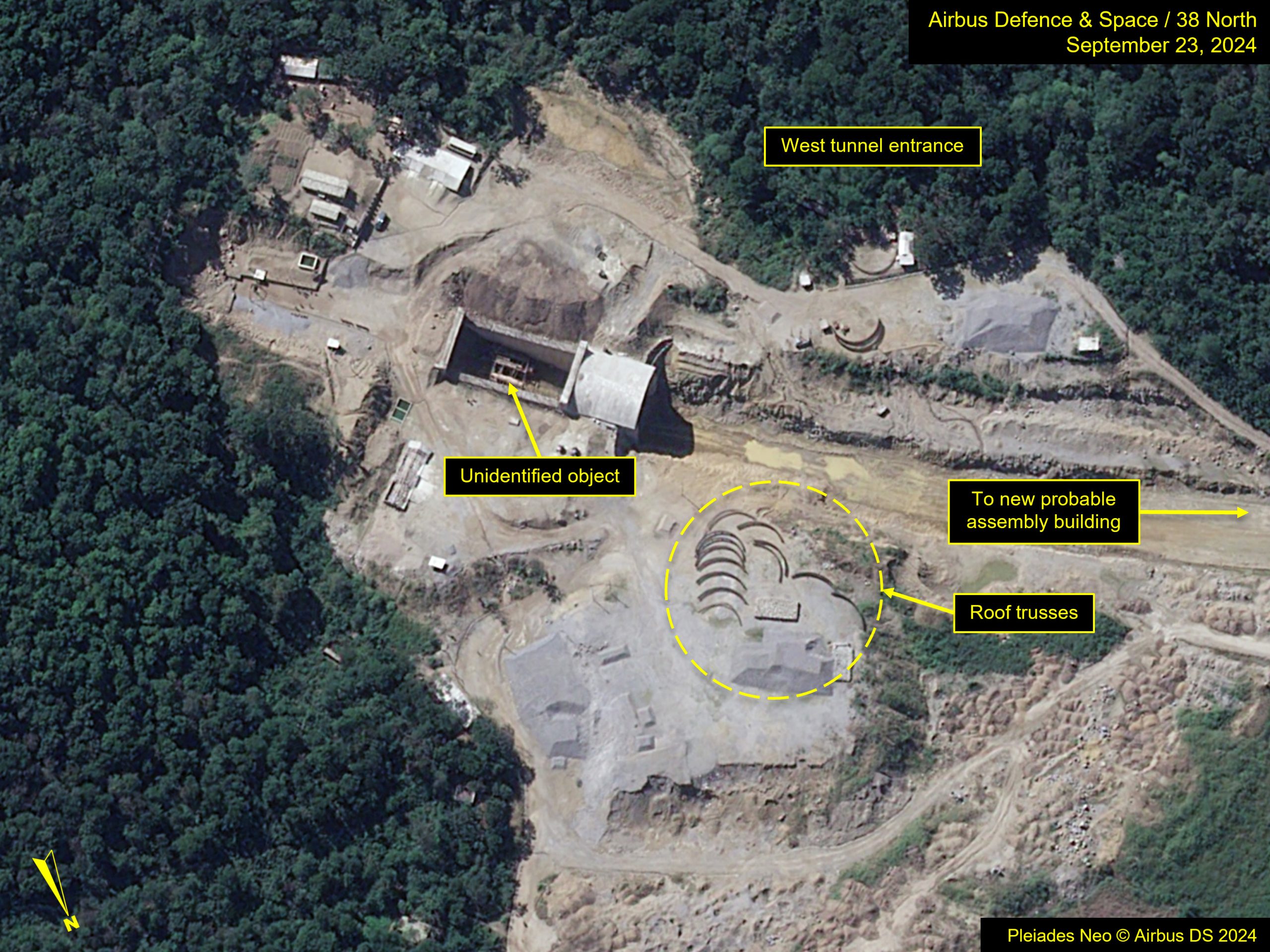

Figure 3. Activity at the west tunnel entrance includes a large rectangular opening. An unidentified object possibly related to construction is observed inside. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

East Tunnel Area

Construction has slowed at the east tunnel entrance. Some digging activity near the entrance was observed on imagery from September 2024. Major work at this entrance may be complete, save for finishing cosmetic touches.

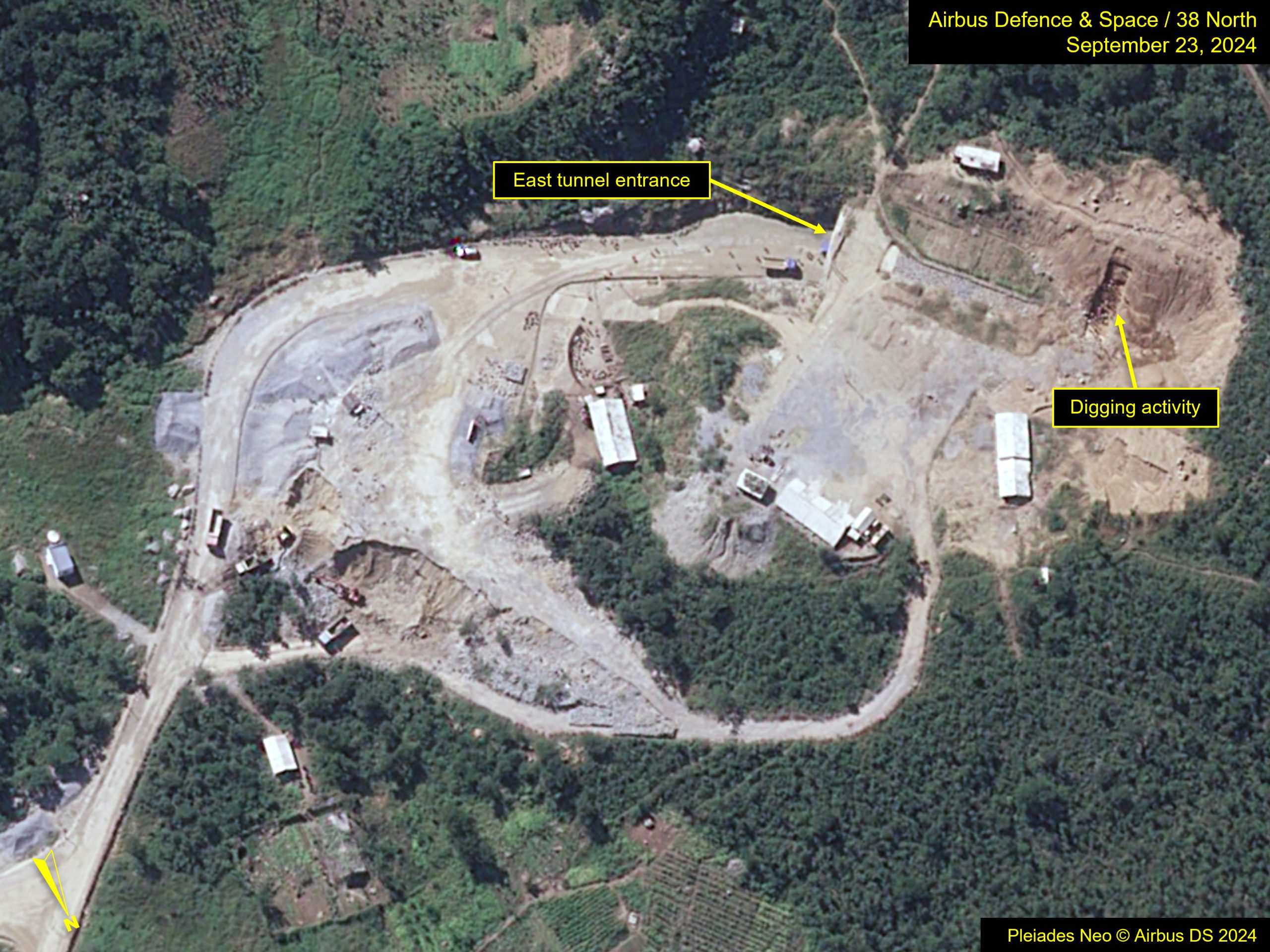

Figure 4. Little activity has progressed at the east tunnel entrance, save for some digging work on top of the tunnel entrance. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

Coastal Launch Pad

No observable activity has occurred at the coastal launch pad.

Ahead of the May 27 satellite launch attempt, two roadside revetments were constructed at the entrance to the coastal launch pad and covered in camouflage netting. The netting—initially used to conceal support vehicles parked in the area—was removed between July 19 and August 8.  Two trucks are present at the revetments on imagery from September 23, possibly related to road work in the area.

Just south of the costal launch pad is an area containing support buildings constructed in the spring of 2023. At this location, in support of the last launch, a structure was erected to cover the presence of launch support vans with camouflage. Imagery from September 23 reveals no vehicles or vans to be present, but the netting remains in place.

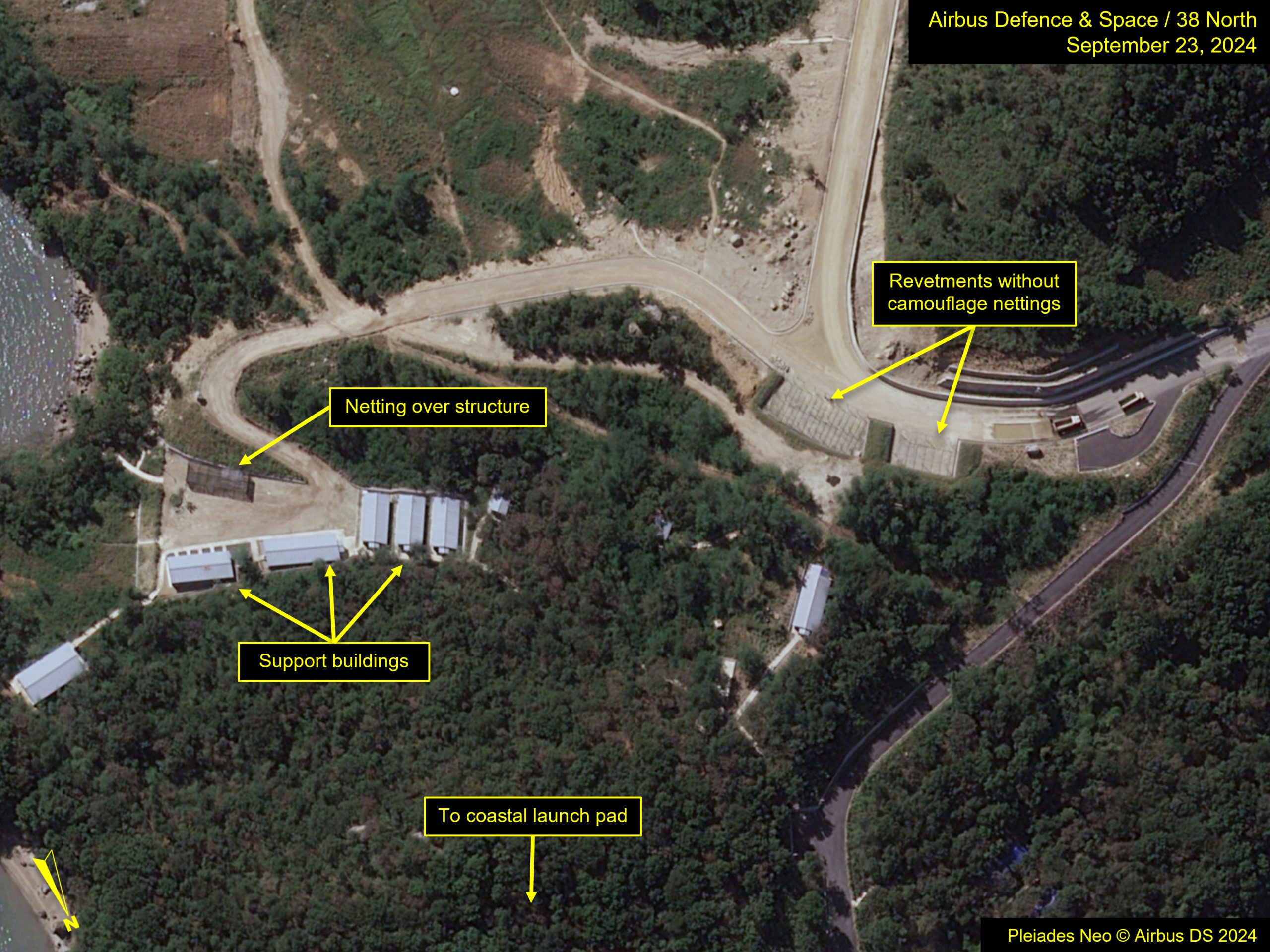

Figure 5. Nettings have been removed that once concealed two parking revetments at the entrance to the coastal launch pad. The camouflage netting remains atop another parking structure constructed prior to the May 27 failed launch attempt. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

Main Launch Pad

The main launch pad remains quiet. Work appears to have resumed on one of the nearby fuel/oxidizer bunkers. However, no significant progress has been made and vegetation has grown within one of the building’s footprints.

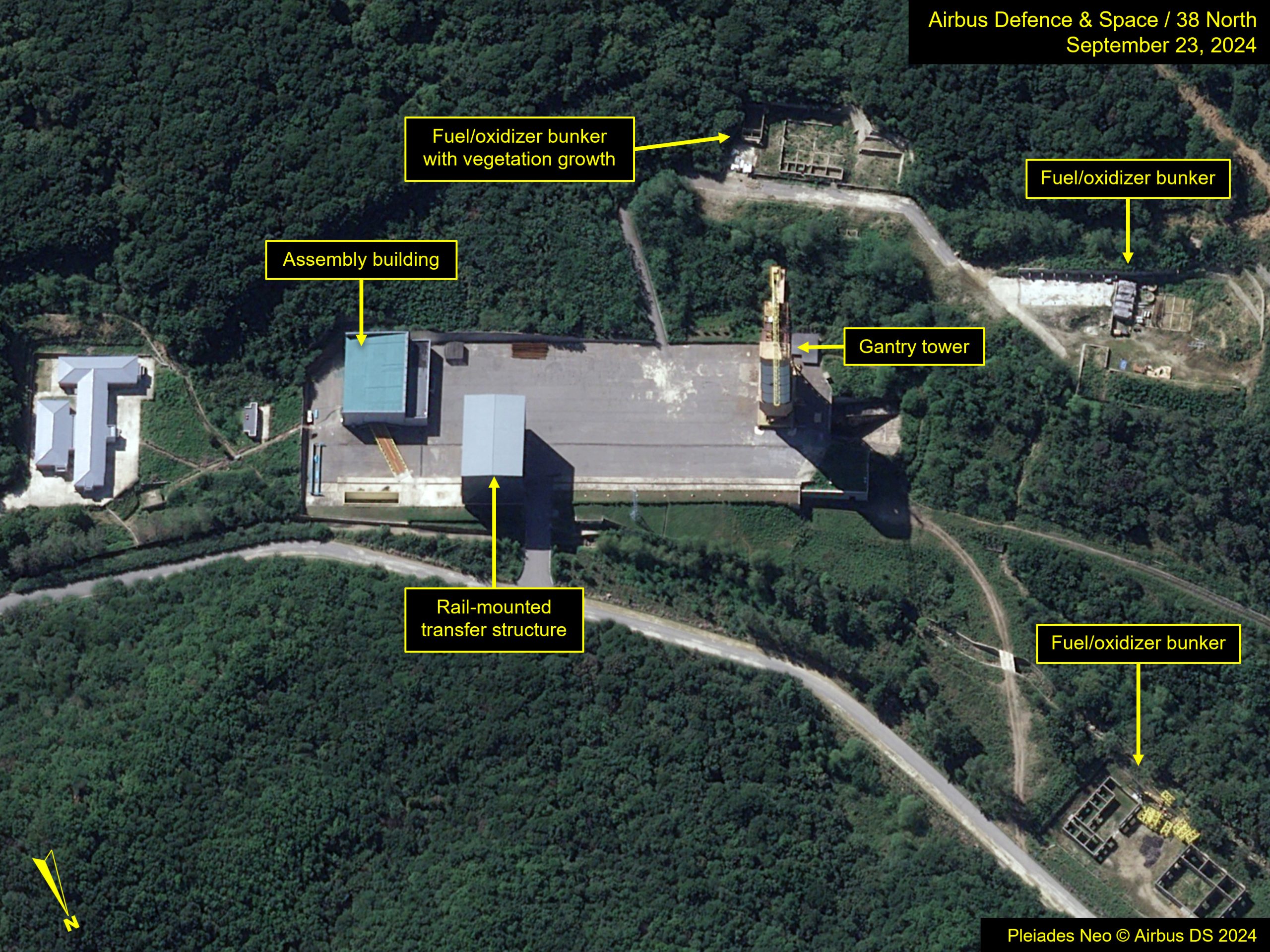

Figure 6. Little observed activity has occurred at the main launch pad. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

 Engine Test Stand Area

At the Vertical Engine Test Stand (VETS), the guides in place for moving the retractable shelter appear to have been replaced. On imagery from late June, bulk construction material and a truck were present on the ramp to the VETS. By July 19, the guides had been replaced. No other major activity has been observed over monsoon season at the engine test stand area.

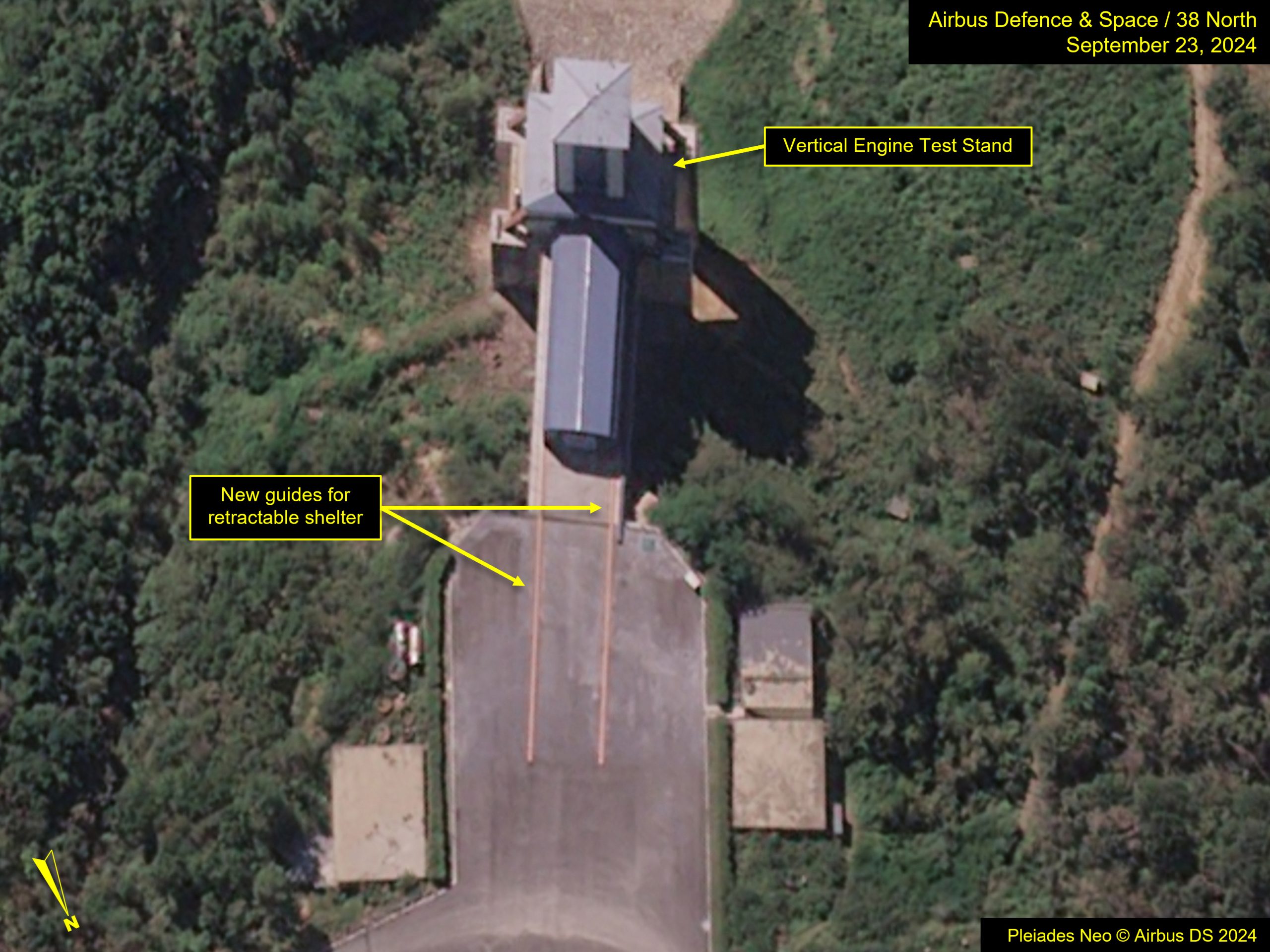

Figure 7. Retractable shelter guides have been replaced at the Vertical Engine Test Stand. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

Tracking Station

Imagery from September 23 shows the mountaintop launch tracking station, located just west of the engine test stand area, has been augmented with a new structure on its roof. The structure appeared in early July. It is likely this structure will house tracking-related equipment. One vehicle is present, possibly a passenger van often observed at the site.

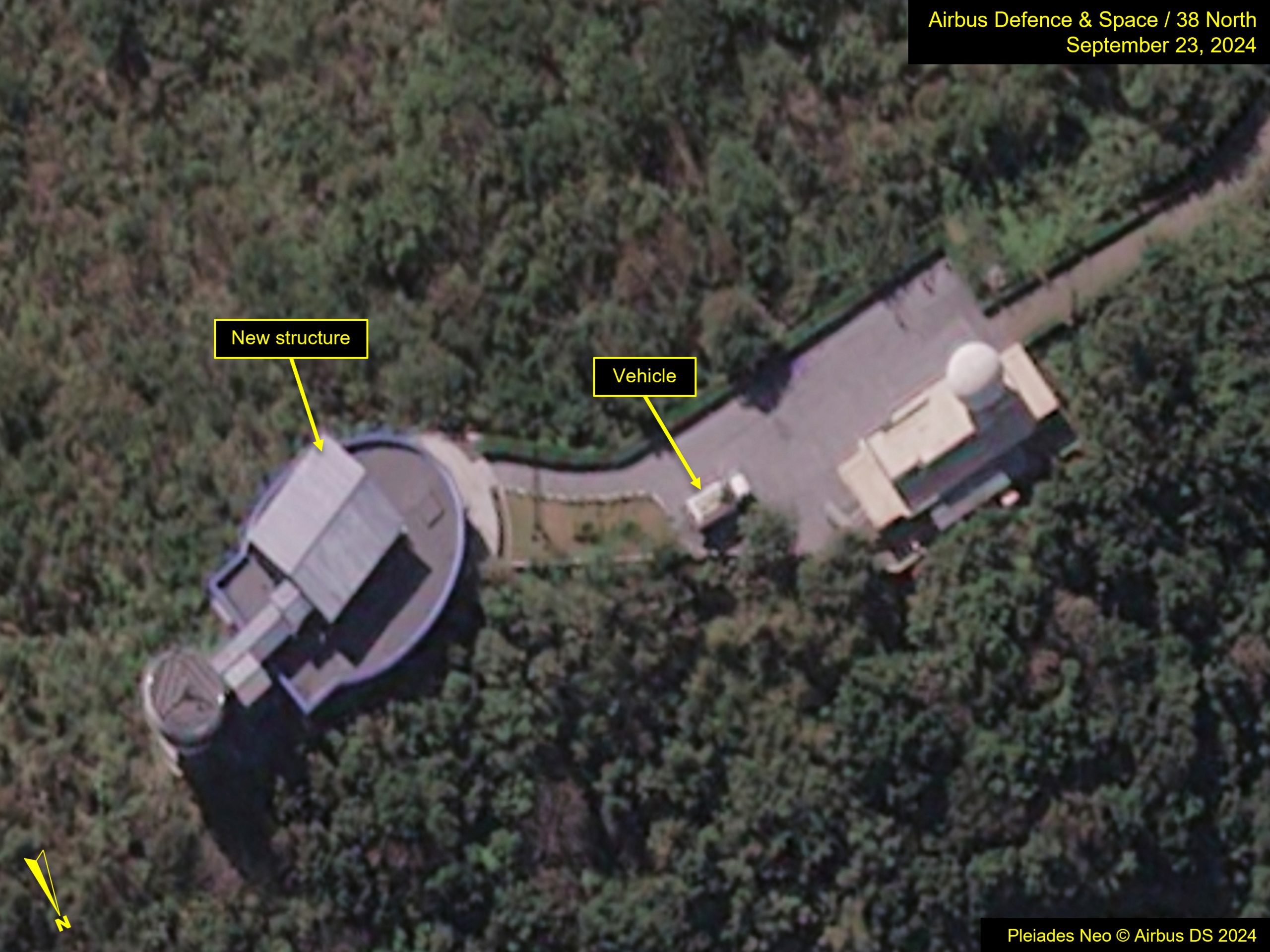

Figure 8. An environmental shelter appeared on the mountaintop launch tracking station in early July 2024. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].

Seaport

Activity continues at the seaport. The new coastal road is now being extended through the small village to the port area.

Dump trucks continue to deposit dirt and move concrete blocks in efforts to extend the jetty out into the sea. Given the large tides in the area, this work suggests the jetty could become a long, wide pier into deeper water, where cargo can be more easily unloaded regardless of the tidal pattern. At the sea’s edge, large concrete blocks continue to be placed at what will likely be the main quay area of the port.

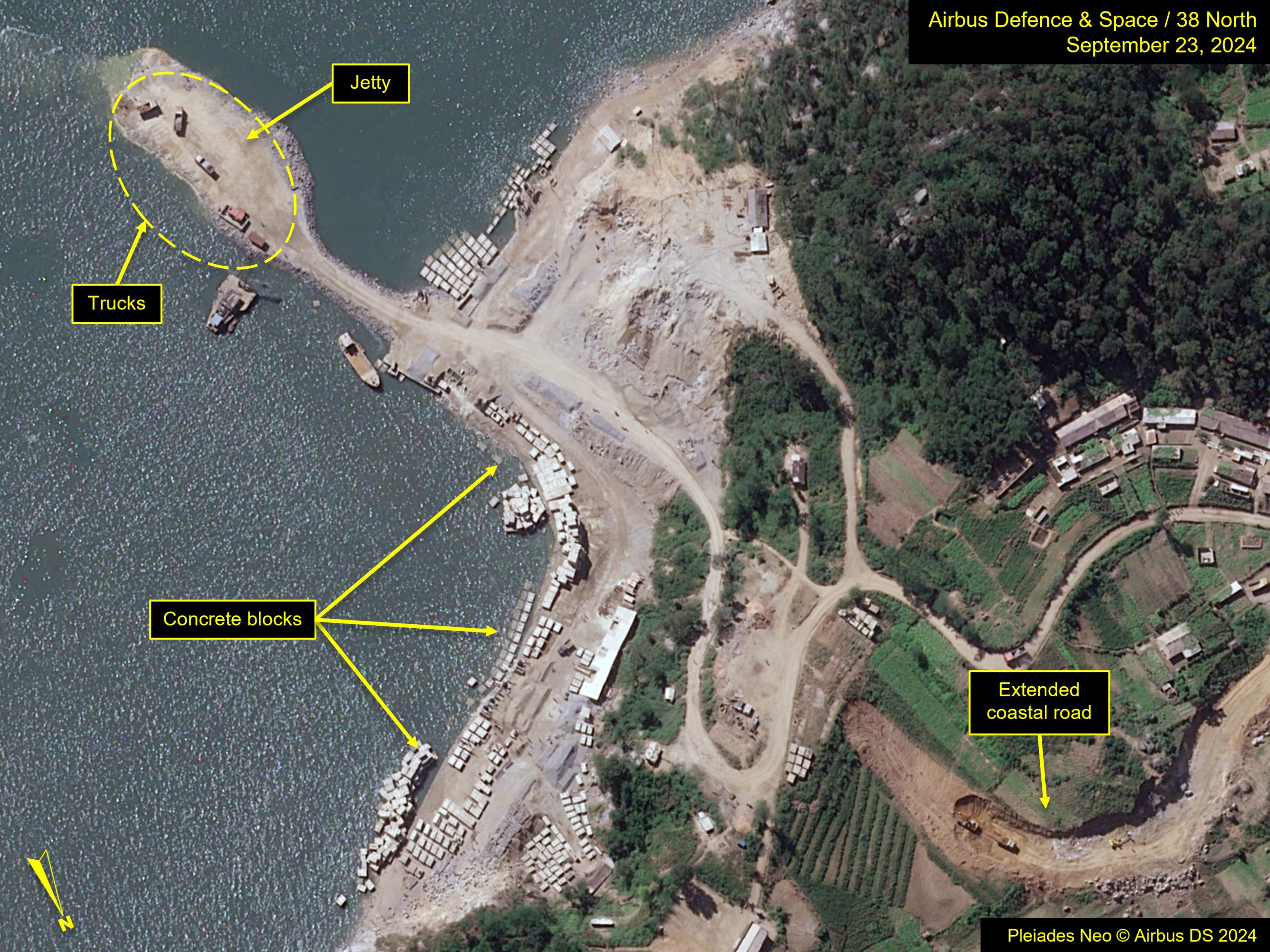

Figure 9. Imagery from September 23, 2024 shows work to extend the coastal road out to the coast. Image Pleiades NEO © Airbus DS 2024. For media options, please contact [email protected].
