Sohae Satellite Launching Station: No Observable Indications of Launch Preparations
Commercial satellite imagery shows that work at North Korea’s Sohae Satellite Launching Station is progressing.
South Korean intelligence reported on October 29 that North Korea appears to be ready to conduct another satellite launch attempt—with the acquisition of parts and technological cooperation with Russia—in what would be its first attempt since the failed launch of the Malligyong-1-1 reconnaissance satellite in May 2024. While modernization efforts progress throughout the site, no typical indicators of an imminent launch have been observed in recent weeks. In addition, North Korea has not made any imminent launch notifications to relevant authorities, a practice they have complied with in the last several satellite launches.
Coastal Launch Pad

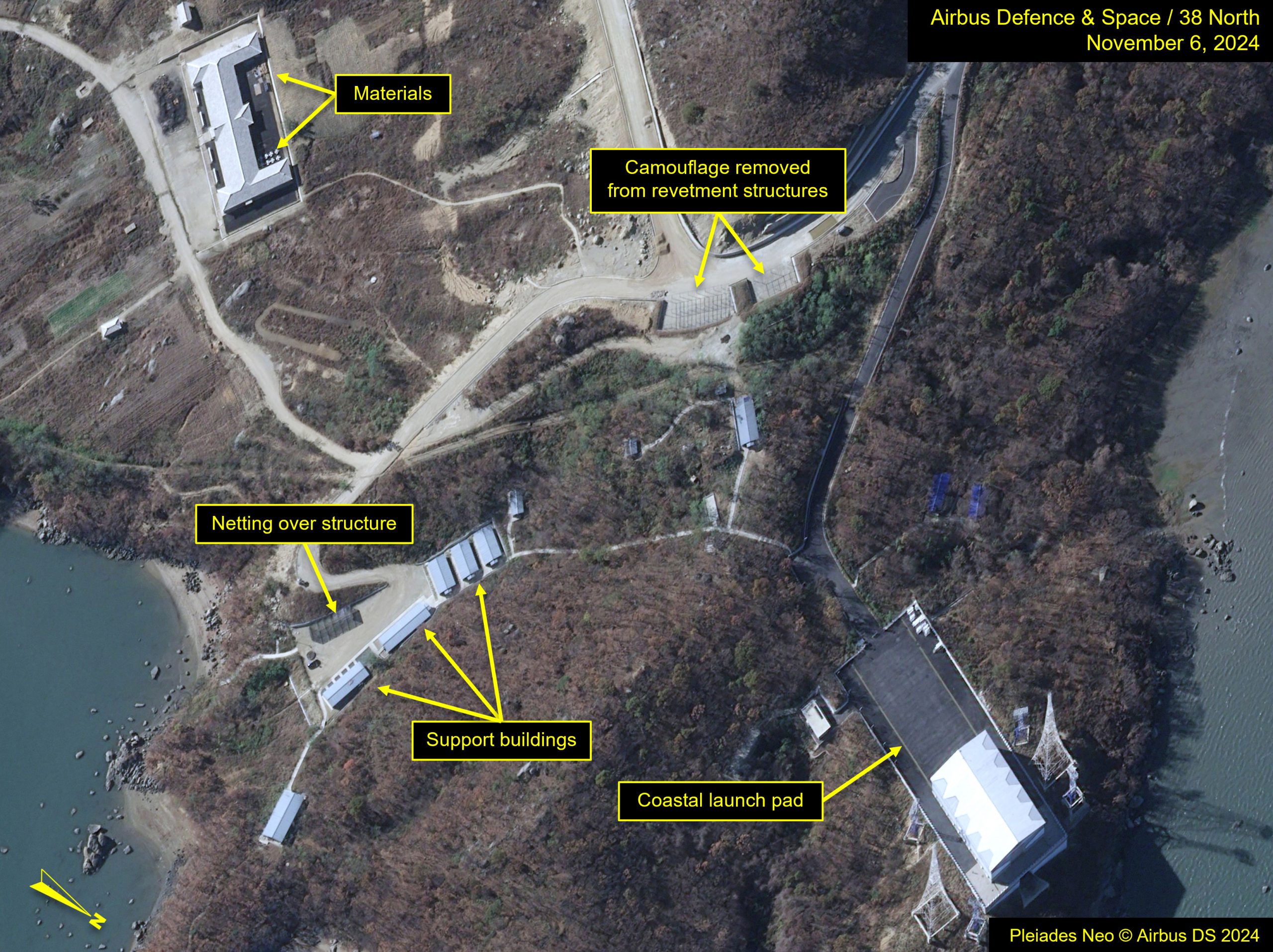

The coastal launch pad has been used for the past three launch attempts. Imagery from throughout October 2024 and, most recently, November 6 shows no observable activities on the pad itself. Around the failed satellite launch in May 2024, support vehicles were observed parked underneath a structure covered in camouflage. Vehicles have not been parked under the same camouflage since late June. On imagery from November 6, the camouflage appears to have been removed from the framing.
Roadside revetments near the entry to the launch pad also remain empty.
To the south of the launch pad, support buildings were constructed in the spring of 2023. At one of the southwest support buildings, paving of the surrounding area has progressed since August 2024, and as recently as November 6, materials remain in the lot.
Tunnel Area

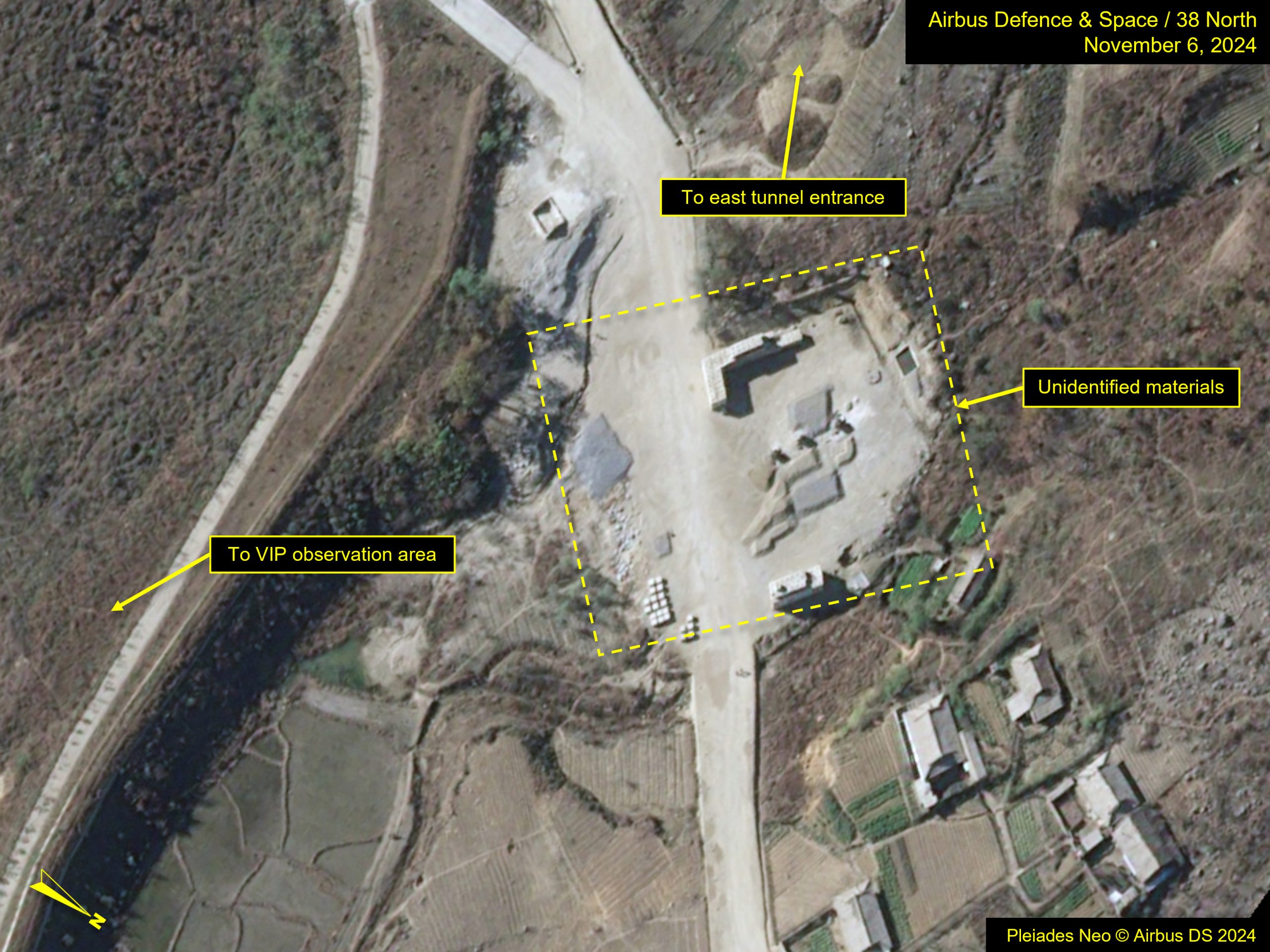

Between the east tunnel entrance and the VIP observation area, a section was cleared—resembling a larger revetment—prior to the last satellite launch. In May, equipment was observed underneath camouflage in this area before the last launch. Imagery throughout September and October shows objects in the same area, the nature of which is unclear.

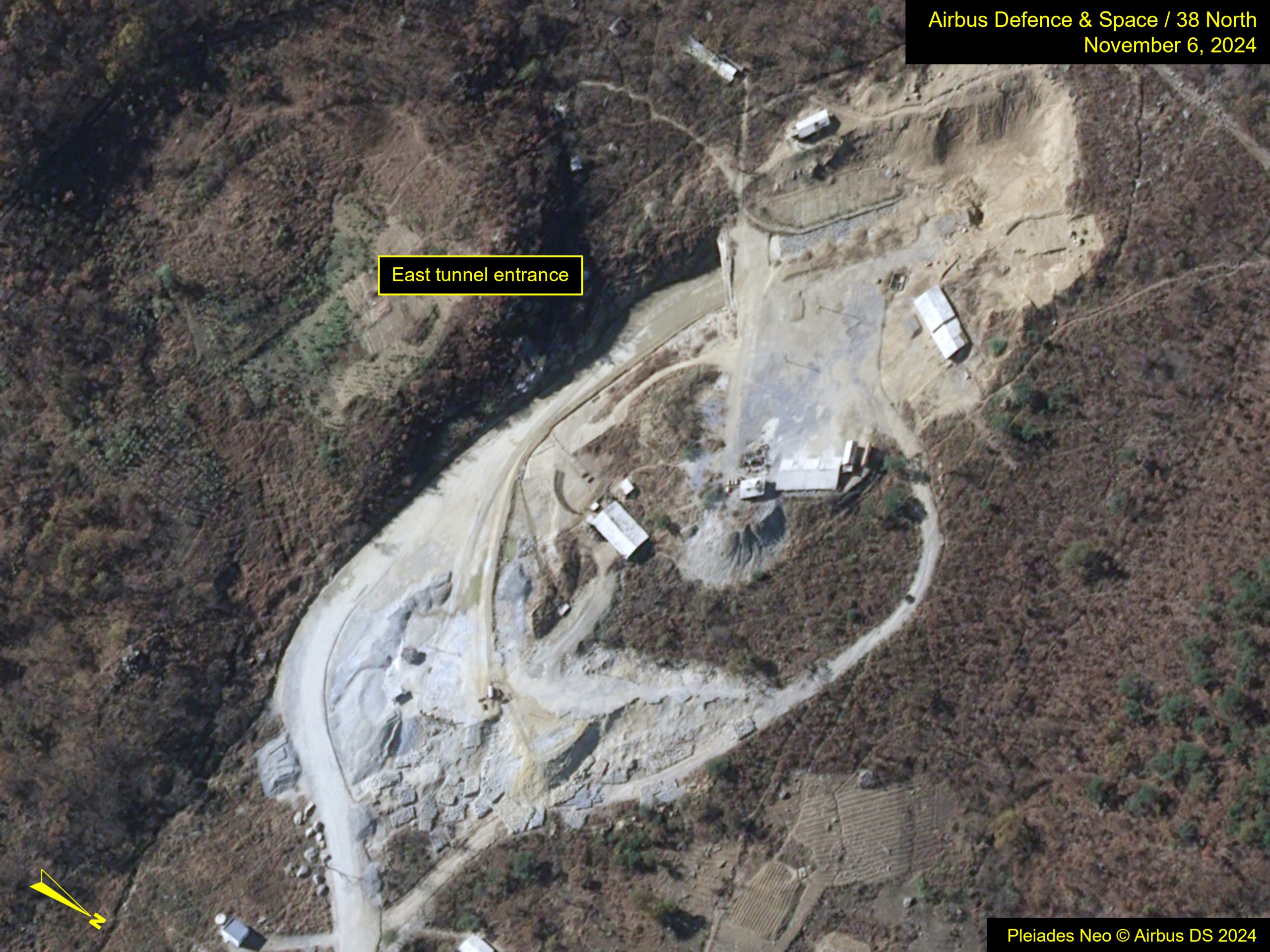

The east tunnel entrance remains quiet, with few observable changes.

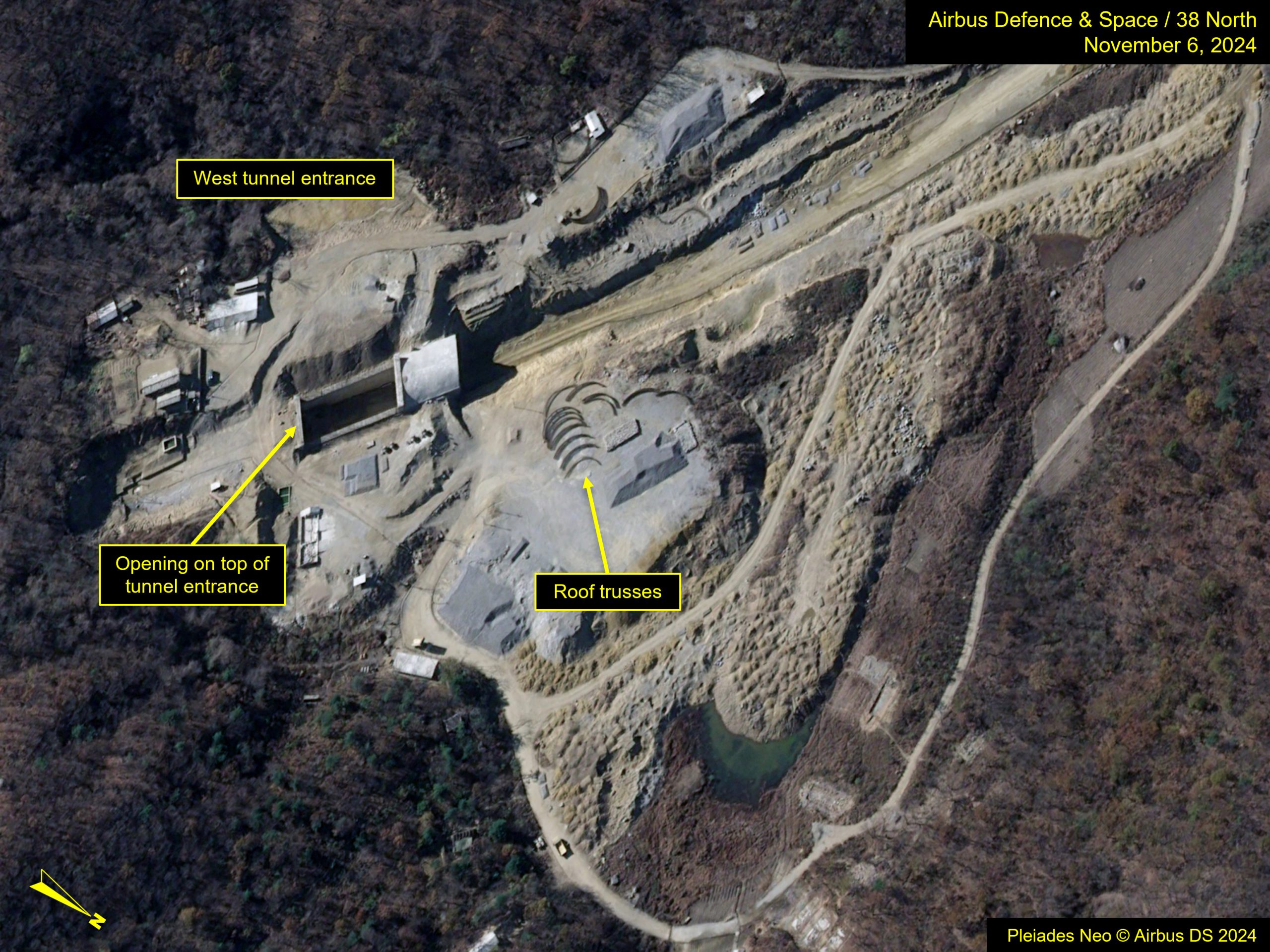

At the west tunnel entrance, work continues. The rectangular opening on top of the tunnel entrance is still visible on imagery from November 6, and roof trusses remain in the surrounding areas.
Engine Test Stand Area

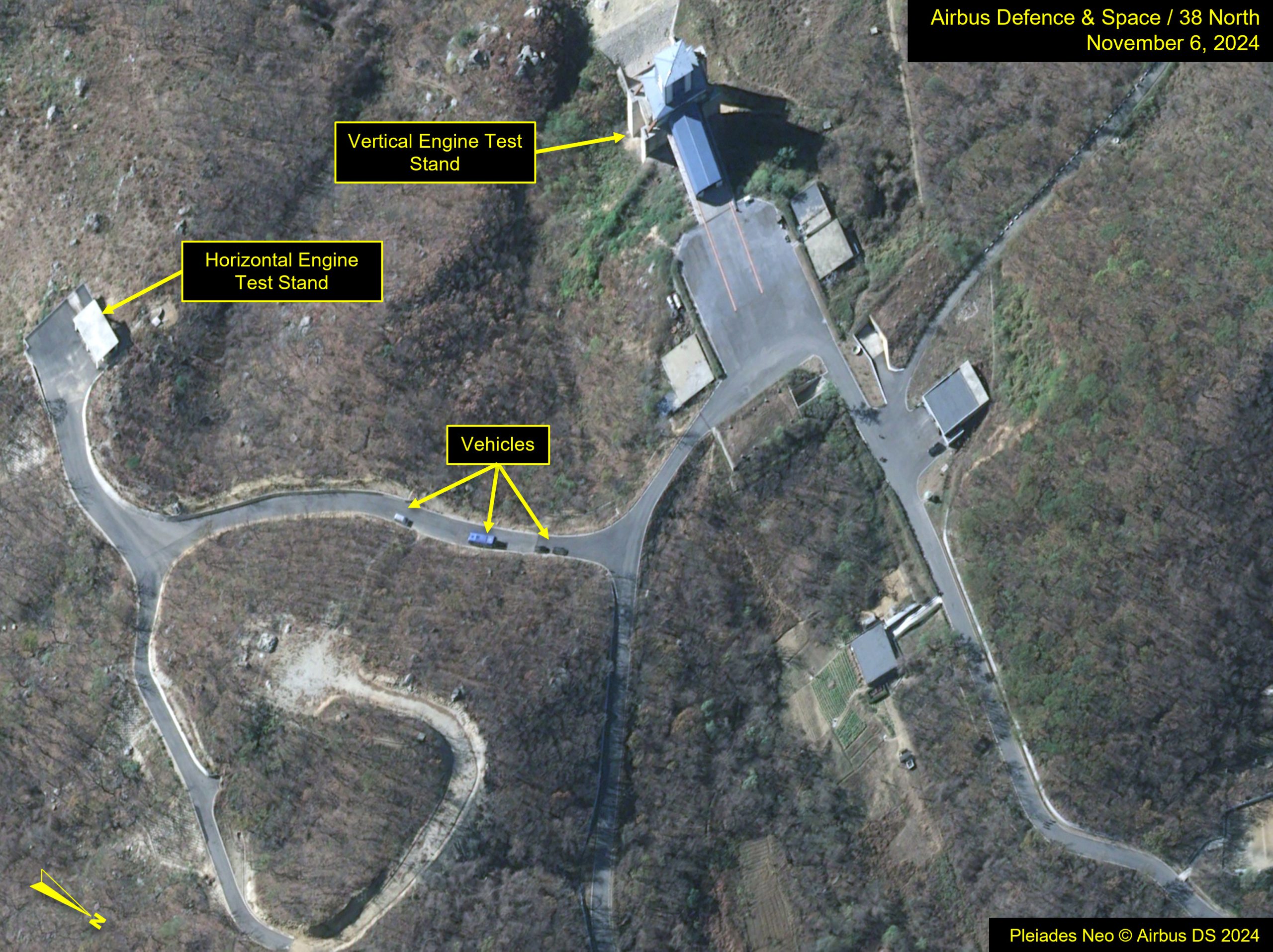

On imagery from November 6, a blue van and smaller vehicles are observed on the road connecting the engine test stands, moving away from the Horizontal Engine Test Stand. While the purpose of this vehicle movement cannot be determined, the vehicles may have been purposed for test monitoring or could have been carrying test-related equipment for installation or a small upper stage for testing.
Other Vehicle Activity

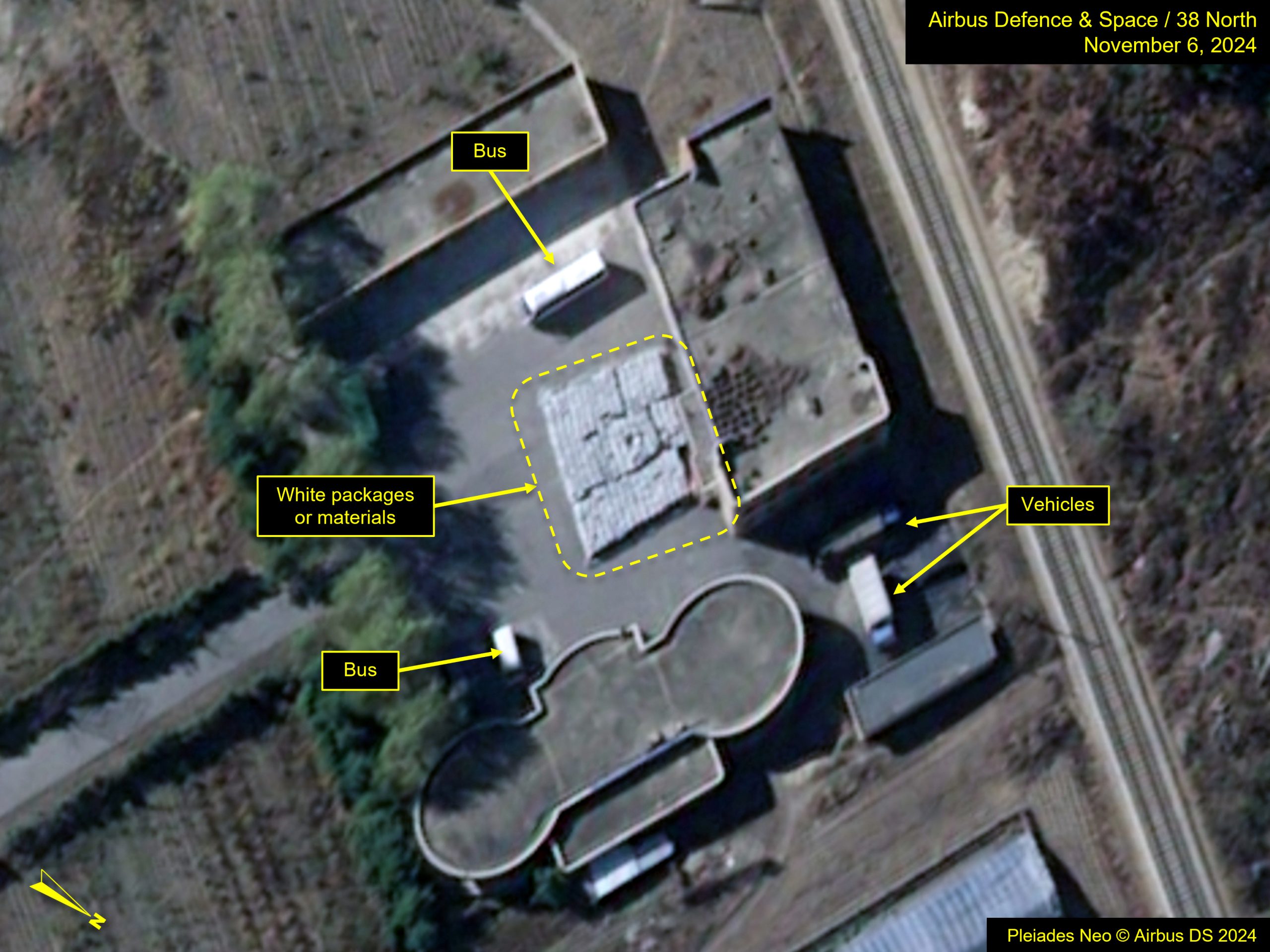

On November 6, buses were observed at the mountaintop tracking station and the administration and security check-in building located at the entrance to the site. Their presence may indicate a VIP visit to the facility.
On that same date, several white packages or stacks of material were observed in front of the same administration and security check-in building. Their purpose is unclear.

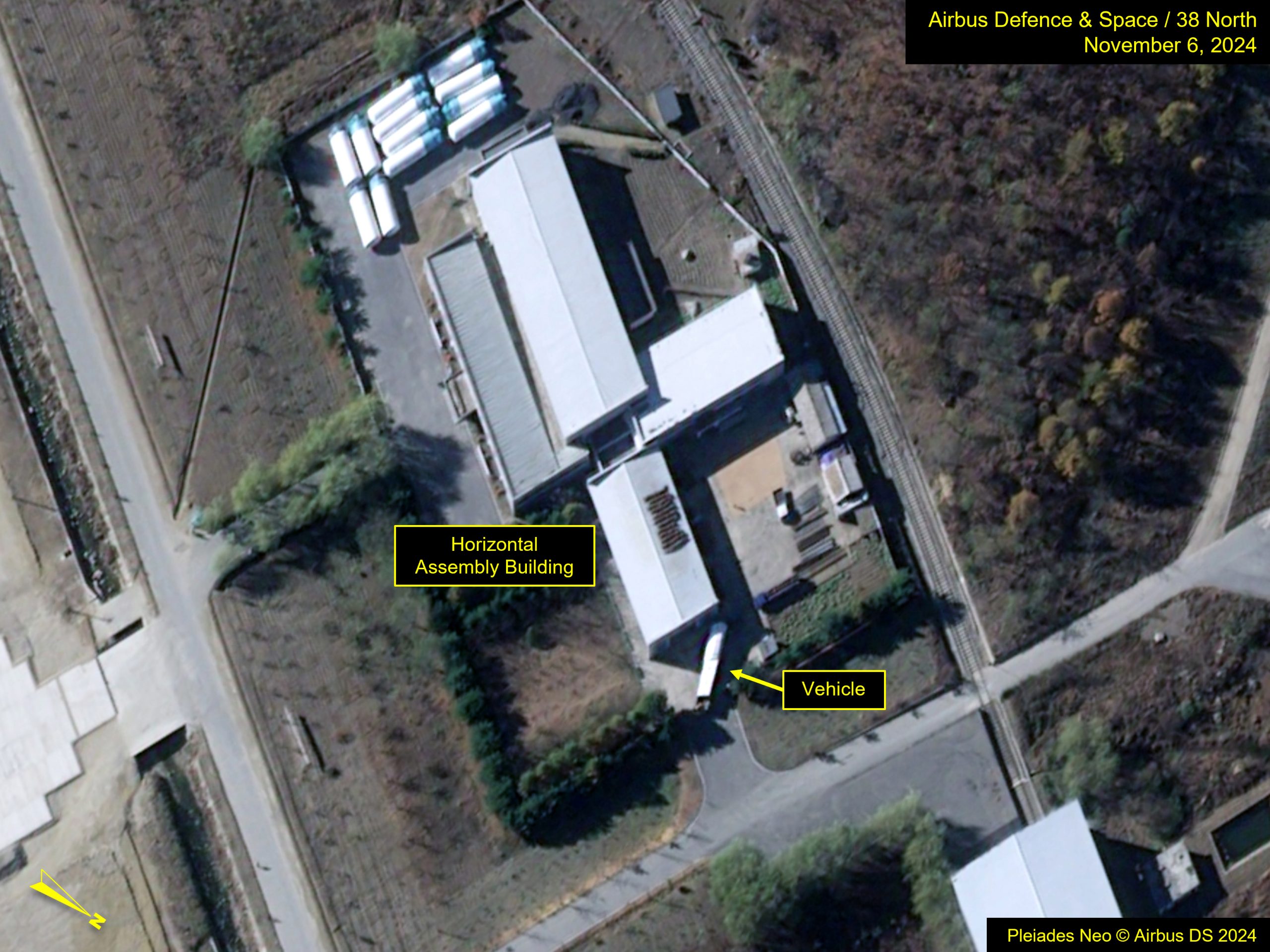

A vehicle was also observed at the old Horizontal Assembly Building.
New Assembly Building

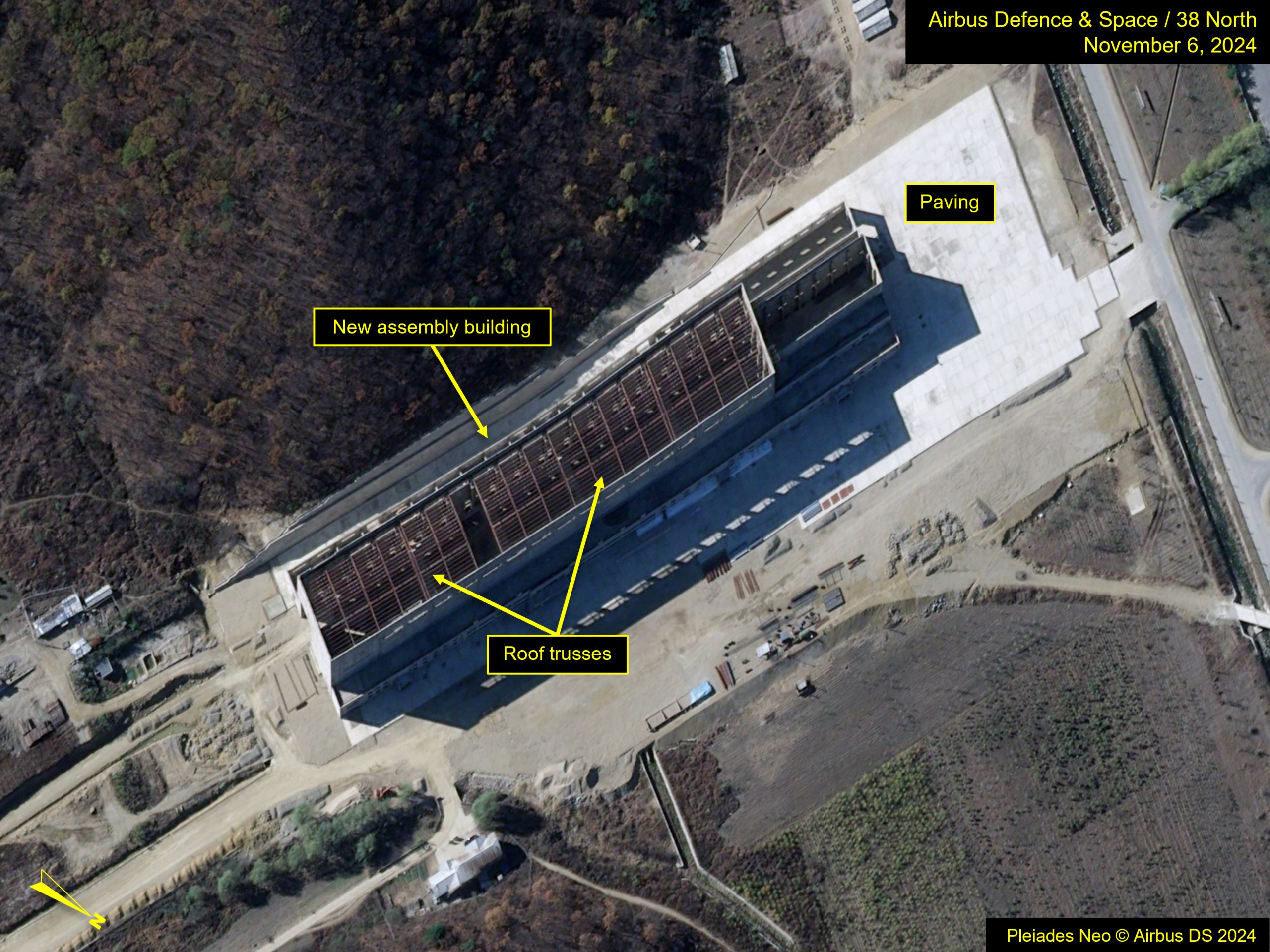

Notably, roof trusses began to be installed between October 8 and October 20. Previous reports observed trusses in the area surrounding the building. By October 31, more than half of the frames have been installed over the top of the building. As of November 6, all but one section of roof trusses has been put in place.
Paving around the perimeter of the new assembly building that began in early September 2024 progresses. Imagery from late October shows the paving blocks begin to connect to the main site road.
Seaport

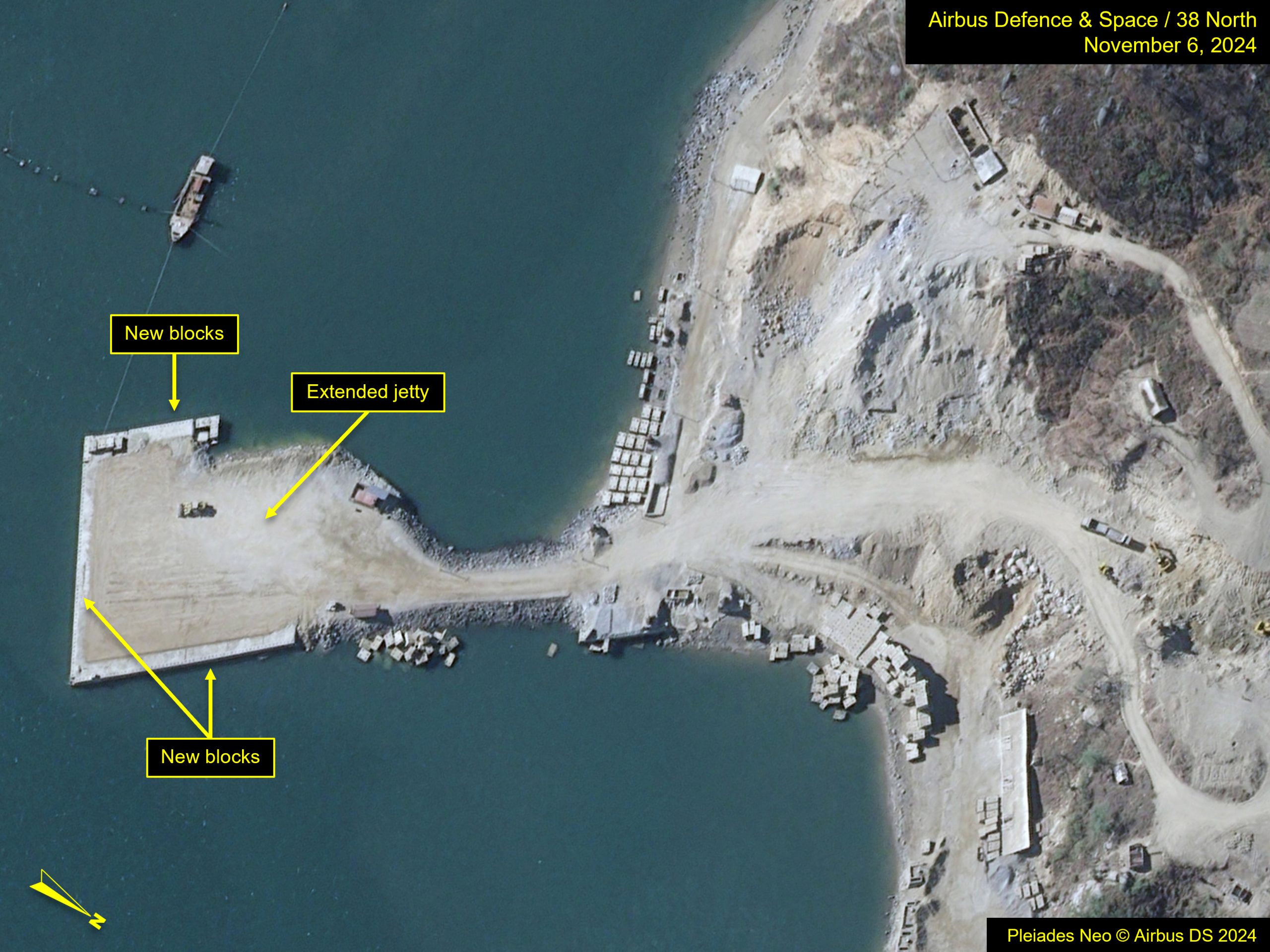

Activity progresses to extend the jetty at the southern seaport. Between September 23 and September 28, blocks began to be placed on the west and south sides of the end of the jetty. In early October, blocks were placed along the east side as well. Work continues through the end of October. This activity is likely to define a dock or quay at the end of the jetty that allows for the unloading of deeper draft vessels.
Work also progresses on the coastal highway, connecting the jetty to the rest of the site.
